Label samples at the machine
Use a consistent sequence such as trial reference, product, film, lane, time and condition. Do not rely on the position of an unlabelled pack in a box or on a video timestamp alone.
Sachet machinery validation guide
A useful trial links the declared product, film, pack and operating condition to measurable results. This guide sets out a practical evidence structure for dose checks, seals, leaks, registration, coding, run video and retained samples without inventing a universal pass standard.

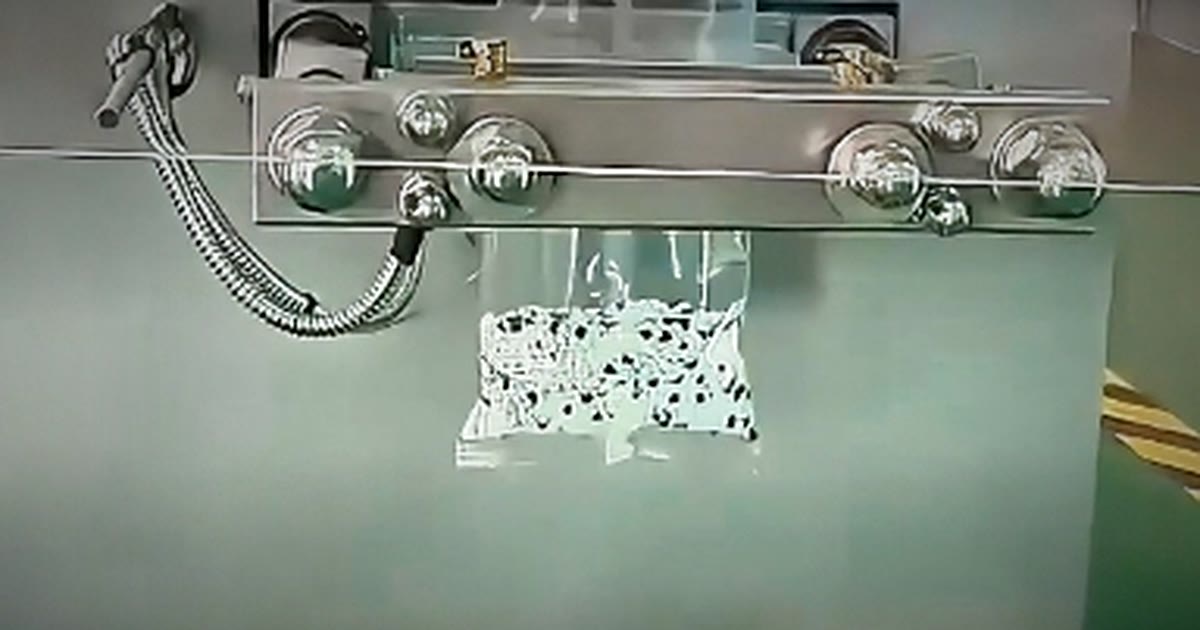

The photograph shows a filled sachet below the sealing mechanism. For a leak check, record the sample reference, the test method and the result.
Start with the decision the trial must support. An early feasibility test may ask whether a product can be dosed and sealed in a proposed laminate. A factory acceptance test may need to prove an agreed machine configuration, pack drawing, output condition, quality checks and documentation. Do not combine these into an undefined demonstration.
List the included products, doses, pack sizes, film structures, lanes, coding formats and operating conditions. Record exclusions and remaining work. Where several variants are intended, identify a worst-case or representative set based on engineering risk rather than selecting only the easiest combination.
Identify the product batch and the properties that affect the process. These can include temperature, density, viscosity, aeration, foaming, particles, bulk density, flowability, moisture and static. Record how the sample was stored, mixed or conditioned before the run. A trial result is difficult to transfer to production when the input condition is unknown.
Identify the film by supplier, construction, thickness, reel width, core, winding direction, seal layer, print repeat and registration mark. Use production-intent film where possible. If temporary film is used, state exactly which questions remain unproven, such as barrier, print registration, code position, opening behaviour or long-term seal performance.
Record model, dosing unit, change parts, forming set, lane arrangement, seal tools, nozzle or chute, date coder and inspection devices. Capture the recipe or principal settings needed to reproduce the run, including fill timing, film advance, seal temperature, dwell or pressure where available, photocell mode and product-feed condition.
Settings should be treated as test evidence, not as universal production values. Film, ambient conditions, product and machine warm-up can affect the usable window. Note any adjustment made during the test and the reason for it.
Define the measurement method, calibrated equipment, nominal dose, permitted range and sample plan before the run. For a multi-lane machine, identify every sample by lane. For a single-lane machine, identify start-up, stable operation, refill, stop-restart or other challenge conditions where they matter.
Report individual results as well as summary statistics appropriate to the agreed plan. A total average can hide one lane running high and another low. Where a volumetric dose is checked by weight, record product density or other conditions needed to interpret the conversion.
First inspect seal location, continuity, wrinkles, channels, trapped product, burn-through, delamination, cut position and opening features. Separate visual workmanship checks from pack-integrity testing. A visually acceptable seal is not automatically leak-tight, and a destructive test may not explain the cause of a defect.
The pack owner should select a leak or integrity method appropriate to the product, laminate, seal and distribution risk. Record conditioning, equipment, test medium or pressure where relevant, sample handling, pass criteria and how failed packs are investigated. Do not apply a generic pressure or duration to every sachet without technical justification.
With printed film, confirm that the photocell tracks the approved registration mark and that artwork remains correctly positioned relative to longitudinal seals, cross seals, tear notch and cut. Check code content, orientation, position, contrast and permanence using the agreed inspection method.
Confirm whether packs leave individually, connected, perforated or in strips, and whether this is compatible with counting, collating, cartoning or manual packing. Record malformed cuts, incomplete separation and any lane-specific pattern.
Define whether the figure is cycles, packs per lane or total accepted packs. Record test duration, number of lanes, product and film replenishment, normal stops, rejects and the point at which the machine was considered stable. Instantaneous display speed is not the same as sustained saleable output.
Where downstream equipment is included, test the line as an integrated system. The filler, film transport, coding, discharge, conveyor, counting and cartoning interfaces need compatible ready, running, fault and stop behaviour.
Label retained sachets with the trial reference, product, film, dose, lane and run condition. Keep dose sheets, seal or leak-test results, exception records, settings, photographs and run-video filenames under the same reference. Samples from start-up, stable operation and agreed challenges should be distinguishable.
The run video should show more than a close-up of moving jaws. Include machine identity, product and film feed, dosing, forming, sealing, coding, cutting, discharge, normal interventions and the operating condition linked to the results. Avoid edits that remove stops or make the test duration unclear.
Classify each requirement as passed, failed, conditionally accepted or not tested. Record deviations, corrective actions, ownership and retest requirements. A signed acceptance should identify the machine configuration and evidence reviewed rather than relying on a general statement that the machine ran.
Factory acceptance does not replace installation and site verification. Utilities, line interfaces, production materials, operator training and the customer environment should be confirmed at the appropriate stage.
| Observed issue | Evidence to collect | Questions to investigate |
|---|---|---|
| Dose variation | Individual samples by lane and time, product condition, refill events and dosing settings | Is the cause product feed, density, aeration, pump or auger behaviour, lane balance or the measurement method? |
| Product in the seal | Pack sequence, nozzle or chute video, fill timing, headspace and product behaviour | Does the product drip, string, dust, bounce or settle into the seal path? |
| Seal or leak failure | Failed pack location, seal appearance, film identity, jaw settings and documented test result | Is the cause contamination, film compatibility, temperature window, pressure, dwell, wrinkle or pack geometry? |
| Print or cut drift | Registration-mark drawing, pack sequence, photocell settings and artwork-to-seal measurements | Is the mark suitable and stable, is the web tracking correctly and is the repeat consistent? |
| One lane underperforms | Lane-labelled dose, seal and cut samples plus feed and tooling inspection | Is the issue confined to dosing, product distribution, web geometry, sealing or cutting on that lane? |
| Output below requirement | Timed run record, stop reasons, refill and reel events, rejects and downstream status | Was the target defined as instantaneous or accepted output, and which process step constrained the run? |
Trial planning questions
Use a representative production batch with the declared temperature, density, viscosity, flow, particle and handling characteristics. A substitute should only be used when its limitations and the remaining risks are documented.
Use the intended laminate and, where print registration or code position matters, representative printed film with the approved repeat and registration mark. Unprinted film cannot prove artwork-to-seal and cut alignment.
The sample plan should be agreed from the process risk, lane count, run condition and acceptance method. It should identify lane and time so averages cannot hide a lane-specific or start-up problem.
Select a documented method suitable for the product, laminate, seal construction and failure risk. The method, equipment, conditioning and pass criteria should be agreed before testing.
Show machine identity and configuration, product and film feed, dosing, forming, sealing, coding, cutting, finished packs, normal interventions and the conditions linked to the accepted results.
Keep the agreed test protocol, machine settings, product and film identification, dose and integrity results, exceptions, photographs or video references, labelled sample sachets and signed outcome.
Define the project around your product and pack
Provide the machine or process under review, representative product, dose, pack and web drawings, film, lane and output requirement, quality risks and proposed acceptance checks. Lancing Ltd can structure the trial evidence around the actual purchasing decision.
Make every result traceable
Dose sheets, leak-test results, photographs, videos and retained sachets are useful only when they can be tied to the same product, film, machine configuration, lane and operating condition. Create the evidence register before the trial and allocate identifiers as the work is completed rather than trying to reconstruct the record afterwards.
| Evidence group | Minimum traceability | Decision it supports |
|---|---|---|
| Product receipt | Trial reference, product and batch, quantity, container, received condition, storage, conditioning, temperature and any mixing or preparation. | Whether the tested material represents the production product and which limitations remain. |
| Film receipt | Converter, material code, laminate, thickness, reel and core, winding direction, artwork revision, print repeat and registration-mark drawing. | Whether the exact production-intent web was tested and can be purchased again under a controlled identity. |
| Machine configuration | Machine, dosing unit, product-contact parts, forming or lane tooling, seal and cut tools, coder, inspection, recipe and principal settings. | Which physical and control configuration produced the retained result. |
| Dose samples | Sample ID, lane, time, operating condition, nominal dose, method, equipment, individual result and disposition. | Whether each lane and declared condition met the agreed dose acceptance plan. |
| Seal and integrity samples | Pack ID, seal location, conditioning, visual result, selected test method, equipment, result, failure location and investigation. | Whether the filled pack meets the defined workmanship and integrity criteria under the test conditions. |
| Output and interruptions | Start and finish, stable period, produced and accepted packs, rejects, lane status, refills, reel events, stops, interventions and downstream state. | Whether the accepted-output figure is reproducible and what constrained the run. |
| Deviation and action | Requirement, observed deviation, affected evidence, immediate disposition, owner, corrective action, retest and closure approval. | Whether an exception is accepted, corrected or remains an open purchasing risk. |
| Retained media | Sample label, photograph and video filename, storage location, retention period and link to the relevant run or deviation. | Whether the signed decision can be checked against physical and recorded evidence later. |
Use a consistent sequence such as trial reference, product, film, lane, time and condition. Do not rely on the position of an unlabelled pack in a box or on a video timestamp alone.
A conditional outcome should identify missing production film, untested formats, short run duration, unavailable downstream equipment or any substitute product. This prevents an early feasibility result being mistaken for full acceptance.
Use the quotation checklist to connect each requirement to included tooling, options and responsibilities, and the film and seal guide to control the approved laminate and test method.
Imagine a two-lane trial using a nominal 10 g dose. For this arithmetic example only, the approved trial range is 9.8–10.2 g. Lane A samples are 9.6, 9.7 and 9.6 g; Lane B samples are 10.4, 10.3 and 10.4 g. The combined mean is exactly 10.0 g, yet every individual sample falls outside the example range. These invented numbers illustrate the accounting issue; they are not a machine performance claim, a legal quantity rule or a recommended sampling plan. The product owner must define the actual acceptance criteria and statistically appropriate test plan.
Retain the lane identity, sequence and operating condition for each pack. Compare relevant product-feed and dosing conditions rather than adjusting both lanes solely to improve the overall mean. Identify whether samples came before or after replenishment, a pause or a setting change. Repeat the agreed test after any correction and keep the original failed record. The final report should make clear which machine configuration and conditions produced the accepted result, including any lane that was unavailable or excluded from the run.
A single total reject count can hide a recurring seal or cutting issue confined to one lane. Record defect type and location with pack identity, and distinguish visible workmanship checks from the selected integrity-test result. Link the agreed run duration and active lanes to the count of accepted complete sachets. If evidence from a lane, format or operating condition is missing, mark that requirement as untested instead of letting successful results from the other lanes stand in for it.
